Prepayment at the connection
Match the electrical service, maximum load, enclosure and customer keypad access. STS token entry supports local credit loading; define low-credit, overload and reconnection behaviour in the selected meter configuration.
For mini-grid developers, operators and EPCs
CalinMeters supplies prepaid electricity meters and supporting communication devices for solar mini-grids. We hold stock for mini-grid products, work with a service provider in Nigeria and provide direct technical support from our China headquarters. Start with a coordinated meter, vending and communication configuration, then validate it at your pilot site.
Discuss your project
Mini-grid products are kept in stock. Confirm the model, configuration and quantity to reserve for your rollout.
An existing Nigeria service provider works alongside direct technical support from our China headquarters.
China headquarters responds within 2 hours during its business hours and within 12 hours outside them. This is the initial response time; resolution depends on the issue.
We are developing service-provider cooperation in additional countries. Discuss a service partnership
Match the electrical service, maximum load, enclosure and customer keypad access. STS token entry supports local credit loading; define low-credit, overload and reconnection behaviour in the selected meter configuration.
Agree who runs vending, manages keys, receives payment confirmations and resolves duplicate or failed transactions. Link a payment reference, token transaction and meter account so the operator can reconcile collections with issued credit.
Select cellular or a gateway-based architecture according to the model and site. Confirm radio coverage, gateway backhaul, reporting intervals and the handling of delayed data. Local token entry and remote communications have separate availability requirements.
Plan single-phase household connections separately from three-phase shops, workshops, pumps and other productive-use loads. CT-operated metering requires a defined CT ratio and the appropriate external load-control arrangement.
Adapted from the supplied Calin four-step deployment guide. The final work instructions and keypad codes must match the selected model and firmware.
Allocate meters and gateways to the site. Record device IDs, agree the configuration and provide the device list for registration. Select a representative sample set for pre-deployment testing.
Connect sample meters, CIUs and gateways, verify backhaul, create test accounts and confirm that meter data reaches the management system. Test each gateway group before dispatch to site.

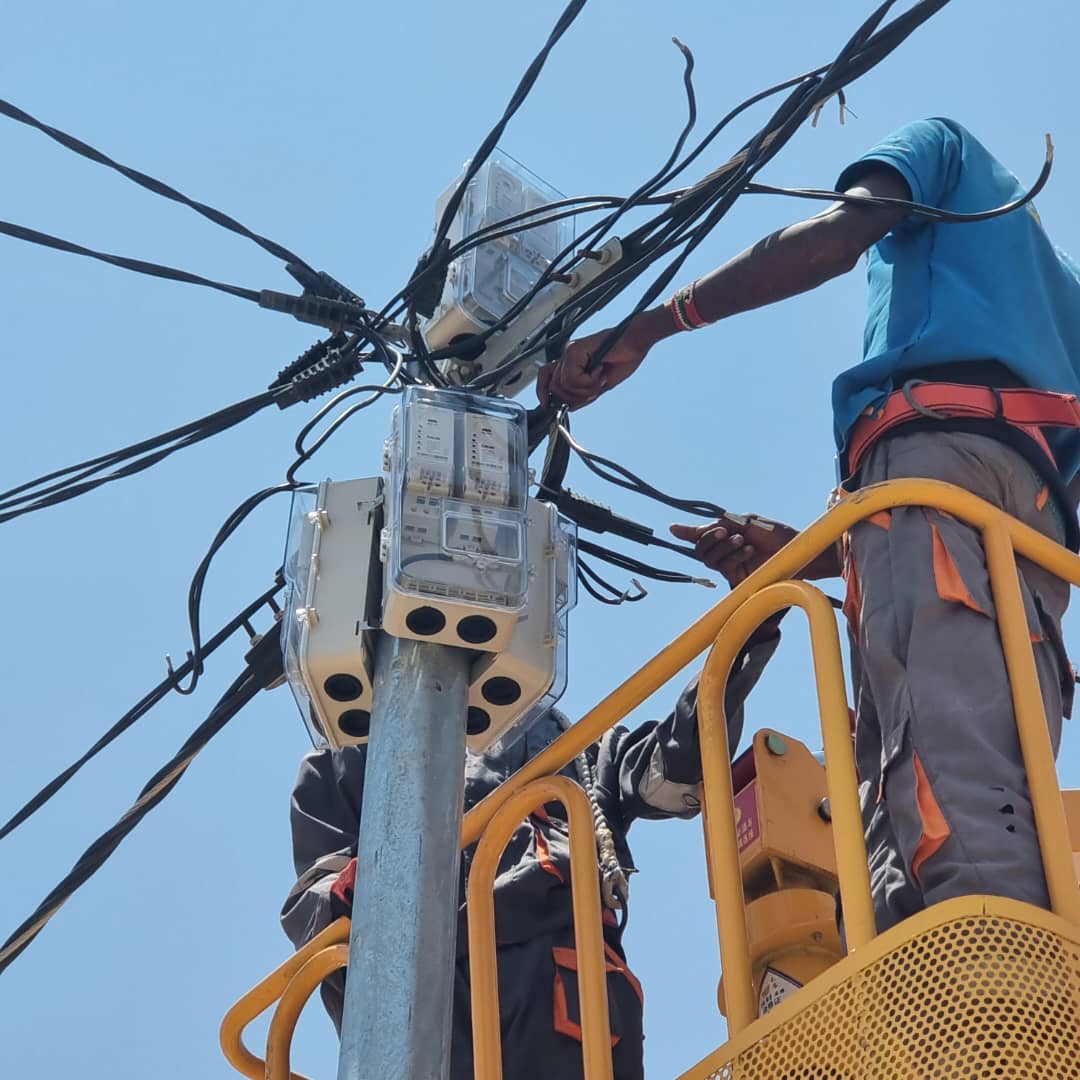

Map the actual service area, test candidate gateway locations and check connectivity at each meter position. Install the devices and associate each connection with the correct operator account.
Verify power, activation, customer supply, token loading and data reception before the field team leaves. Record exceptions, hand over the device/account list and agree the maintenance and escalation contacts.
Proposed acceptance plan for your project, not a report of achieved field results. Set numerical thresholds and observation periods with the operator before testing.
Record the installed meter, CIU, gateway and customer-account mapping. Acceptance evidence: a signed device list and a successful test transaction for each sampled configuration.
Test valid recharge, rejected or repeated tokens, payment exceptions and balance updates. Acceptance evidence: matched transaction records and an exception-resolution log.
Test representative indoor/outdoor locations, loss of backhaul and restoration of supply. Acceptance evidence: time-stamped read records, recovery observations and a list of unresolved coverage gaps.
Confirm field training, spare-device allocation, account access and escalation. Record open actions and approvals; expand the rollout only after the agreed acceptance criteria are met.
Company project material documents supply of split-keypad single-phase meters, three-phase meters and DCUs for a Nigeria electricity-distribution project. The experience covers meter supply, installation planning and system coordination for distribution metering.
CalinMeters currently works with a service provider in Nigeria. Agree the service location, on-site responsibilities and visit arrangements for your project, with China headquarters supporting the technical work directly.
We are developing service-provider cooperation in additional markets. Installation firms, metering integrators and maintenance teams can discuss training, territory coverage, tools, spare parts and escalation responsibilities with us.

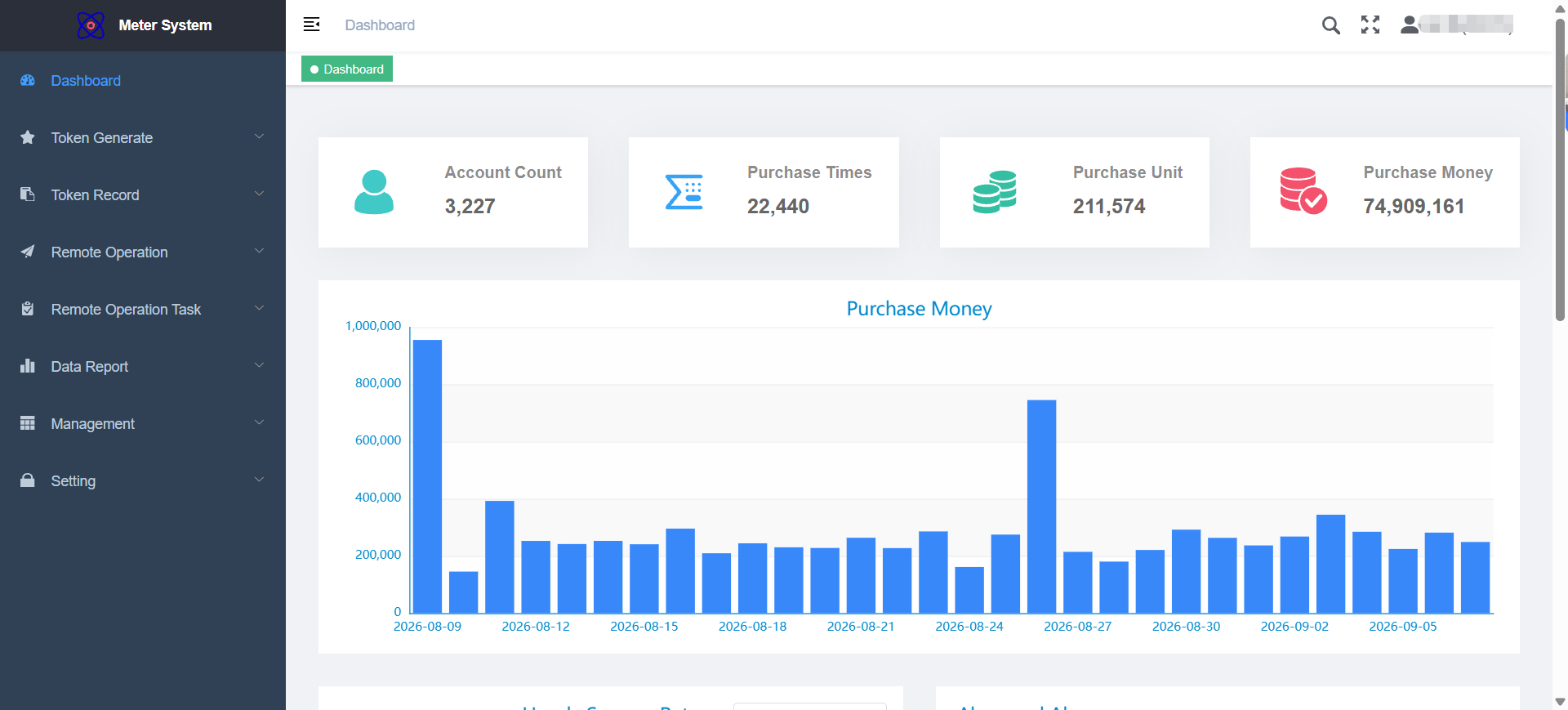

The supplied platform view shows token generation and records, remote operations, reporting and account management. Plan user roles, payment interfaces and reconciliation outputs with the project team.

Project inquiry
Tell us your country, installation and maintenance coverage, team experience and the metering services you can provide.
CalinMeters has a service provider in Nigeria and provides direct technical support from China headquarters. Headquarters responds within 2 hours during its working hours and within 12 hours outside working hours. These are response times; on-site attendance and resolution depend on the issue and agreed service scope. Service-provider cooperation is being developed in other countries.
Yes. CalinMeters maintains stock for solar mini-grid metering products. Share the meter configuration, communication option, quantity and delivery destination so the available batch and dispatch schedule can be confirmed for your order.
No. Local entry of a valid STS credit token and the systems that sell credit are separate. The meter can accept a token through its keypad or CIU without a continuous internet connection at the meter. Token generation, payment confirmation, vending access and reconciliation depend on the selected system architecture and must be confirmed and tested with the operator.
No. A World Bank-funded or other programme-supported project still has its own technical schedules, procurement rules and acceptance requirements. CalinMeters can support a configuration and document review against those requirements; programme funding does not establish approval of a particular meter.
Project inquiry
Share the target country, model or application, quantity, timeline and technical requirements. We will help define the next configuration or cooperation step.
